Home/Projects/Elevated Conveyor Tear Down & Replacement
Project

Elevated Conveyor Tear Down & Replacement

Sooner Coal Plant · Oklahoma
SMPHeavy Lift

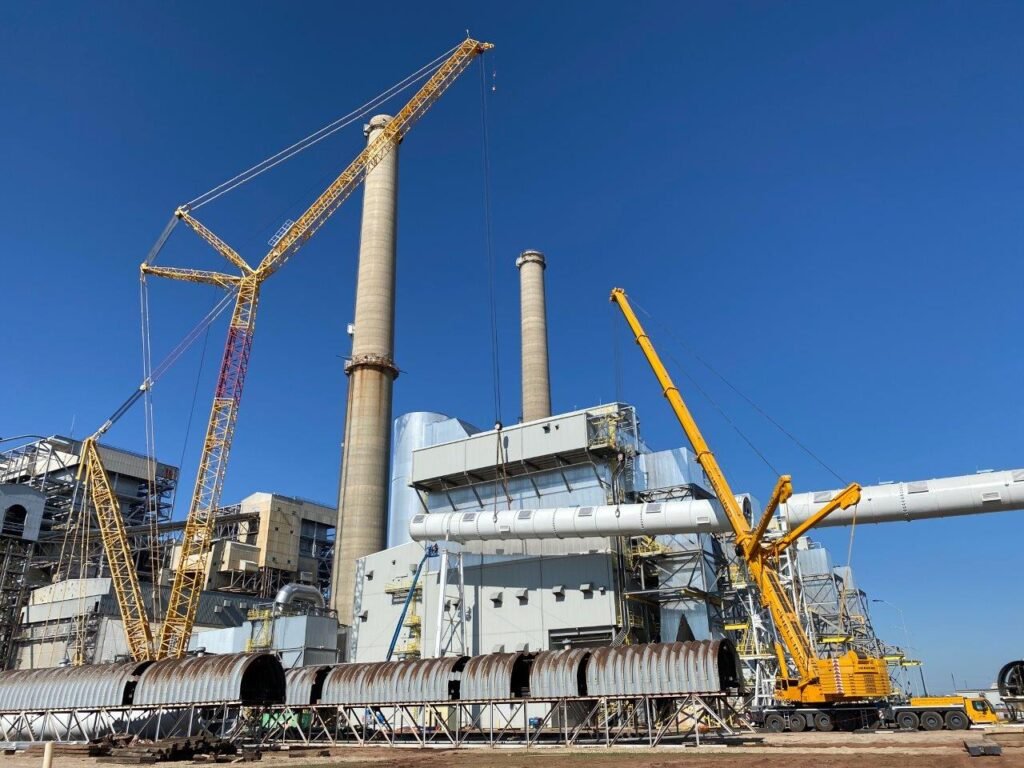

Tear-down and replacement of a 2,100-foot dual coal conveyor system, executed during a 90-day plant outage with 43 major lifts — work over water, multi-shift operations, delivered through spring 2020.

Our project team's extensive experience and planning with heavy critical loads was instrumental to winning and completing the work successfully.

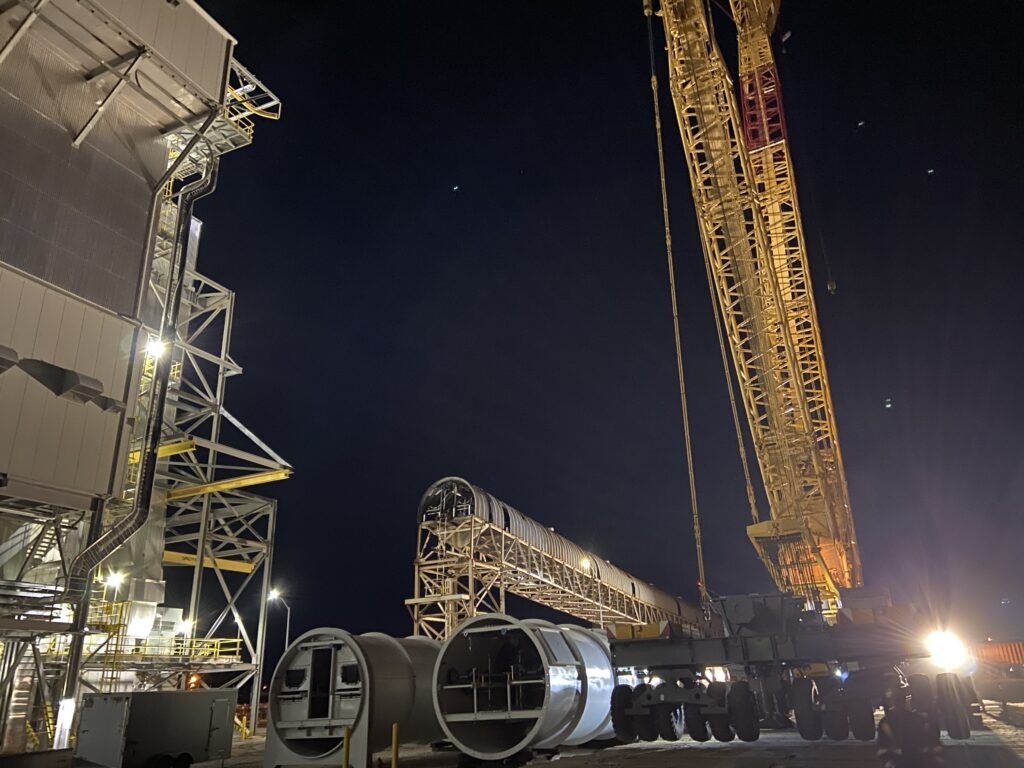

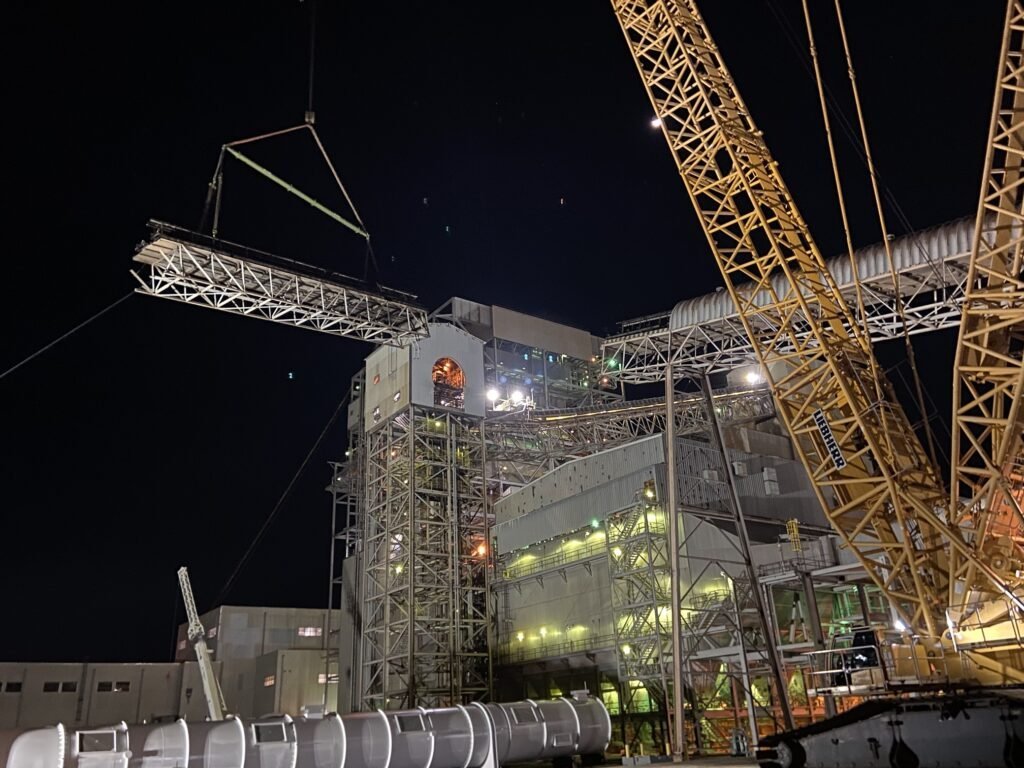

The GBI team ran multiple shifts and overcame several challenges including work over water and completing work during the spring 2020 COVID-19 pandemic. It was a great job done with GBI safety and quality.

Scope of Work

Removal & Replacement

Removal of Existing Structure

  • (2) 36″ wide side-by-side conveyors
  • ~2,100 feet long
  • 300 HP motor
  • Belt speed 635 FPM
  • 740 TPH
  • One center walkway
  • Below-conveyor truss
  • Covered gallery

Installation of New System

  • Enclosed gallery
  • (2) 36″ wide side-by-side conveyors
  • ~2,100 feet long
  • 740 TPH with surge to 850 TPH

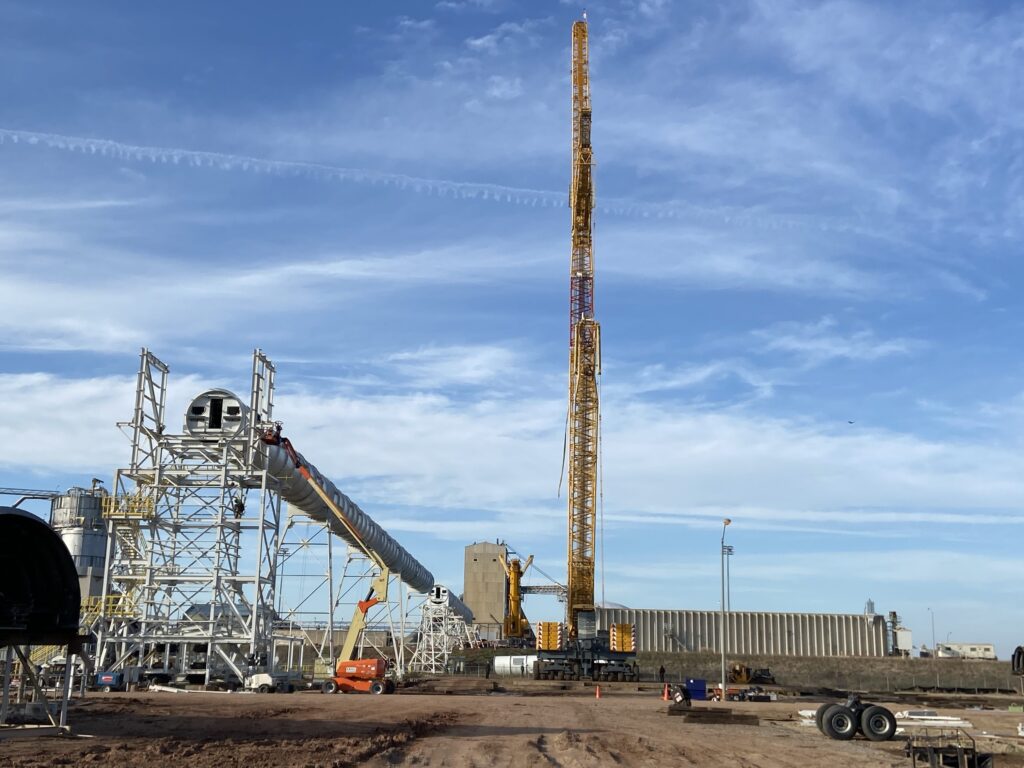

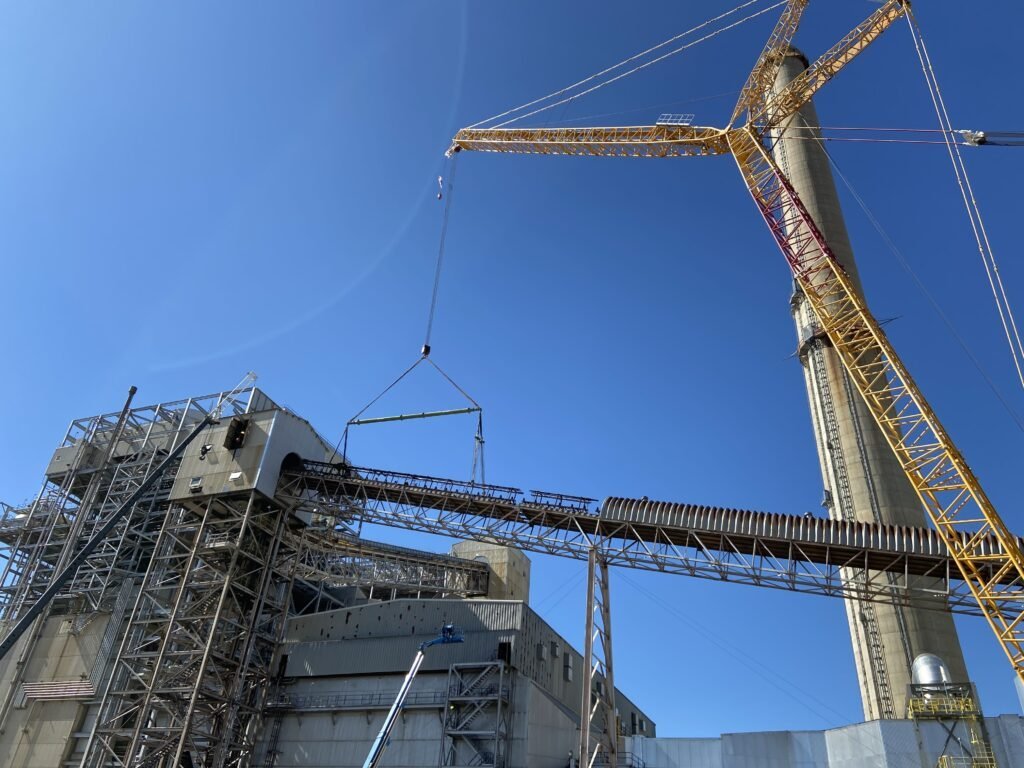

(23) Lifts of Trussed Gallery Sections

  • < 120,000 lb lifts, up to 122′ radius

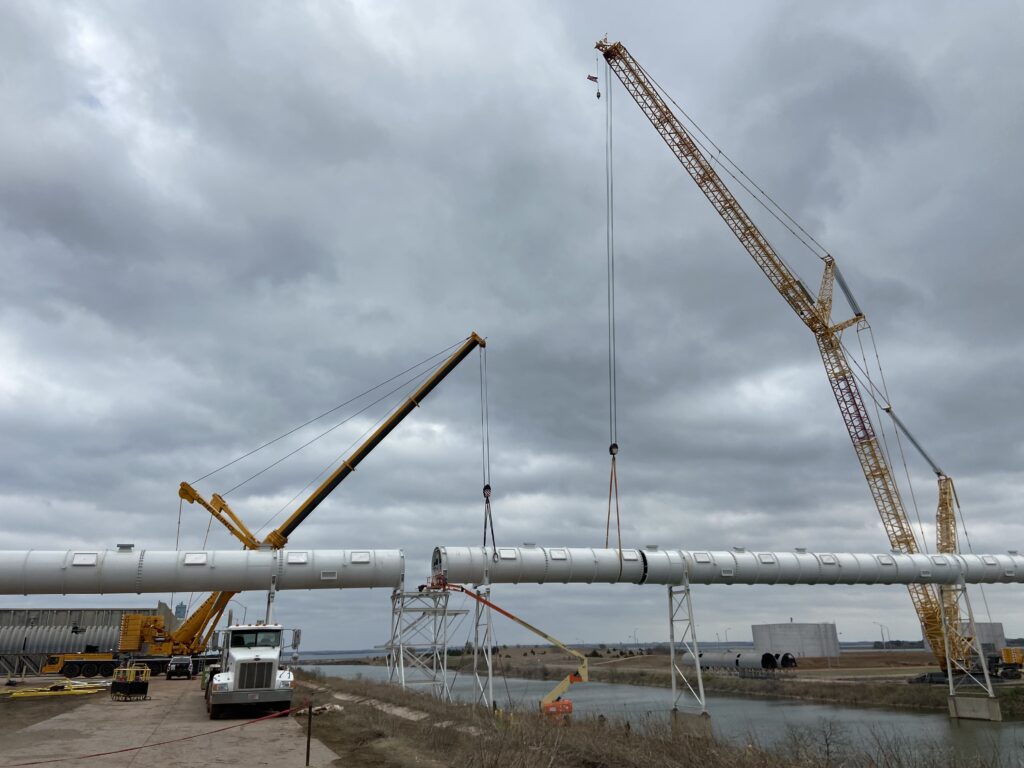

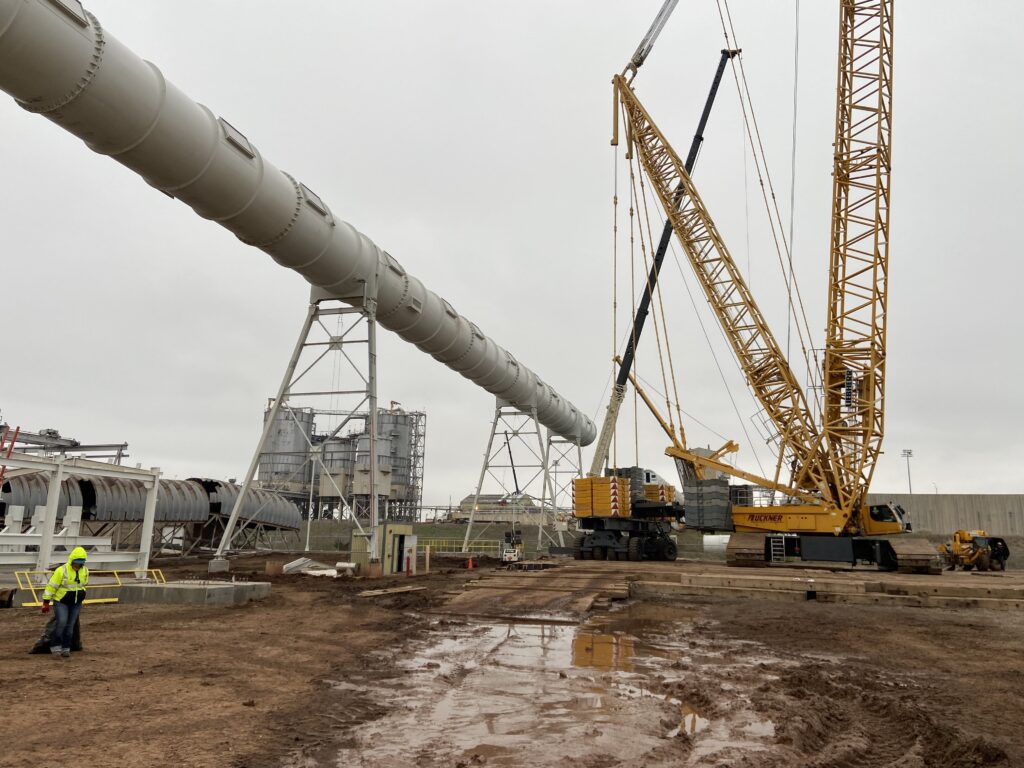

(20) Lifts of New Tube Gallery Sections

  • < 189,700 lb lifts, up to 149′ radius
